Any drag/drop changes you make to the scheduled start or due date of a job, task or milestone may mean that one or more tasks or milestones no longer lie within the timeline of the parent job. For example, moving the scheduled start date of a job forward by 10 days may result in the job's final task starting after the job's new due date.

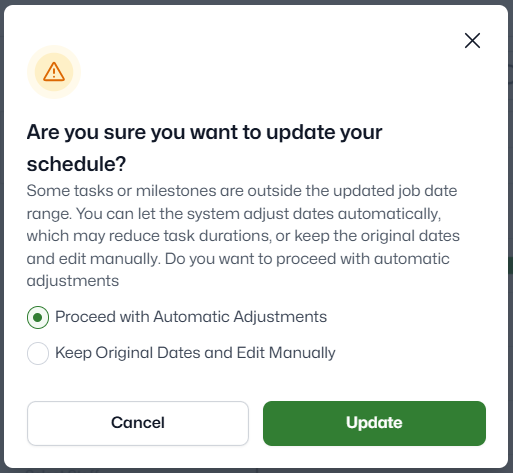

If such a situation arises, prompts you to choose how to deal with this issue:
The result of choosing either option depends on which dates you are adjusting on the timeline.
When you are updating job dates
If you select automatic adjustments:
- and if the new duration for the job is unchanged, then shift all tasks and milestones to match the new job dates. For example: job moved back from January 1-20 to February 1-20, maintaining a duration of 20 days but starting 31 days later, then shift all tasks and milestones back by 31 days.
- and if the new duration for the job is reduced, then:
Step | Description |
---|---|
Calculate Task Duration | Task duration = task_end_date - task_start_date. |
Adjust Task Start Date |
If task_start_date is before the new job start date:
|
Adjust Task End Date |
If task_end_date is after the new job end date:
|
Adjust Milestone Due Date |
If milestone_due_date is before the new job start date:
If milestone_due_date is after the new job end date:
|
- Example
The following table shows how automatic adjustments are made to task and milestone dates by when the job duration is changed.
Original Job Date: 2025-01-01 to 2025-01-31
New Job Date: 2025-01-10 to 2025-01-25
Tasks and Adjustments:
Name Original Start Date Original End Date Original Duration (days) Adjusted Start Date Adjusted End Date Adjusted Duration (days) Task 1 2025-01-02 2025-01-05 3 2025-01-10 2025-01-13 3 Task 2 2025-01-15 2025-01-20 5 No adjustment needed No adjustment needed 5 Task 3 2025-01-05 2025-01-12 7 2025-01-10 2025-01-17 7 Task 4 2025-01-22 2025-01-28 6 2025-01-19 2025-01-25 6 Task 5 2025-01-01 2025-01-20 19 2025-01-10 2025-01-25 15 Milestone 1 N/A 2025-01-04 N/A N/A 2025-01-10 N/A Milestone 2 N/A 2025-01-27 N/A N/A 2025-01-25 N/A
If you select manual adjustments:
- Job dates are updated, but task and milestone dates remain unchanged.
When you are updating task dates
If you select automatic adjustments:
- and the task's start date is earlier than the job's start date, adjusts the job's start date to match the task's start date.
- and the task's end date is later than the job's end date, adjusts the job's end date to match the task's end date.
